Dissassembly of the old FIRST BAPTIST CHURCH of Middletown, Ohio by Reserections, Inc.

October 1...

Original Wall Stencils.                                   Peanut pattern in stone  ... rare ?

Pedro & Juaquin removing roof panels                                    Juaquin

October 8

City Parking lot used to stage truckload           Carpentry used to build containers.

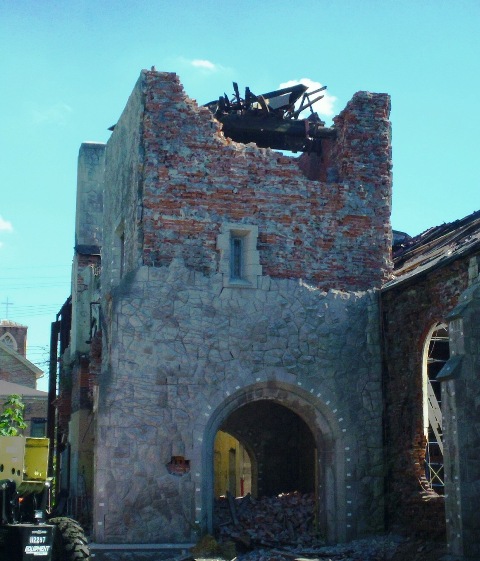

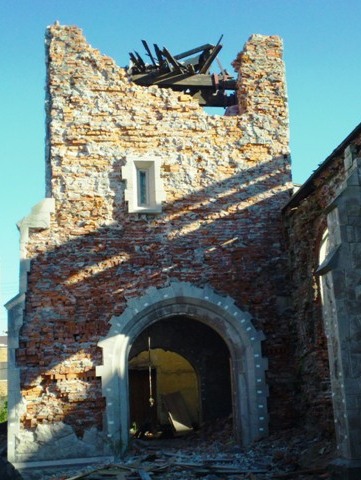

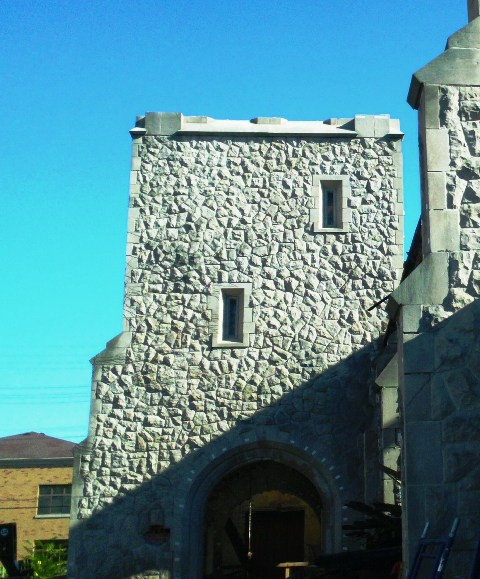

The Bell Tower is coming down ..  Last of the Big Stones.

October 11-16

Pallet 1                                   Pallet 2 & 3                                      Pallet 4

Gettin the Rocks Off   ....  One Days Work

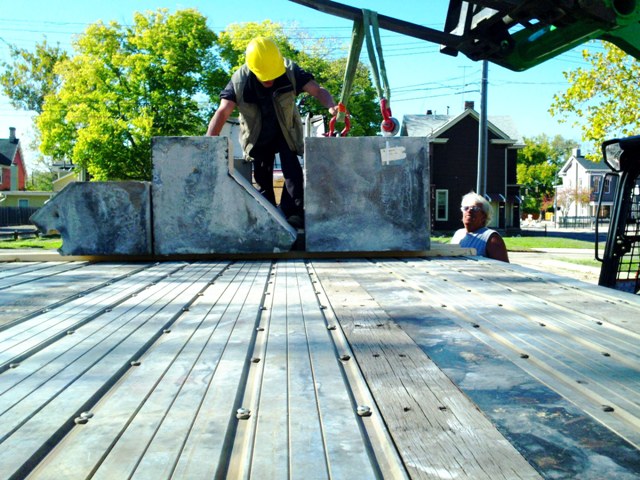

Mohammed  Supervising                              Pedro                                42,000 pounds to Texas

             Roof coming off                                                                    Columns

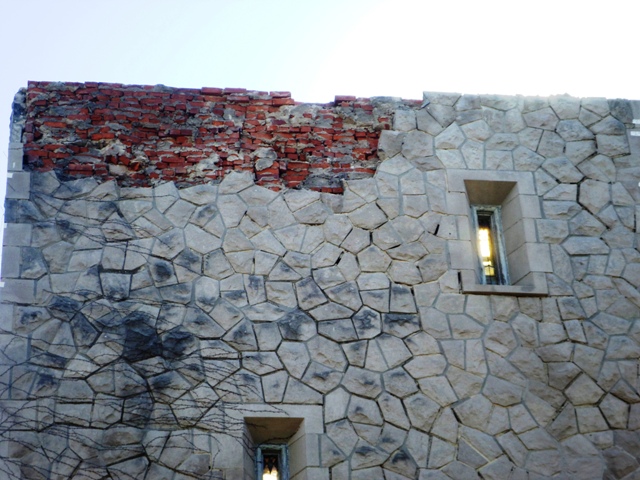

Stones on the south side of the bell tower have much more weathering than other walls.

 Day 1 - 4 Pallets                        Day 2 - 4 Pallets                         Day 3 - 5 pallets

Purlins                                          Stone Removal                           1904 Numbered Stones

Truck # 8 Loading

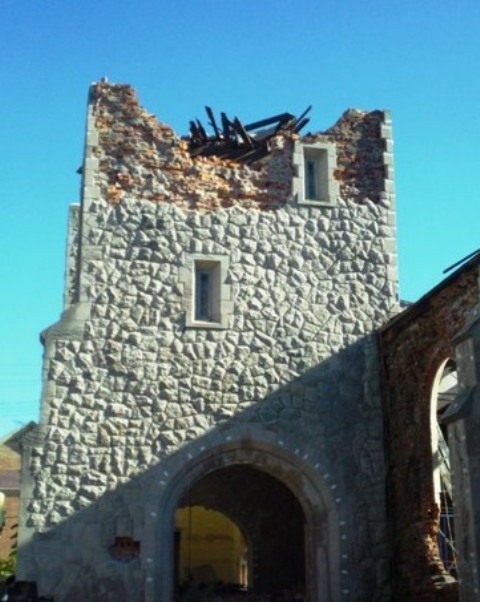

Day 4 - North Tower wall 1/2 done

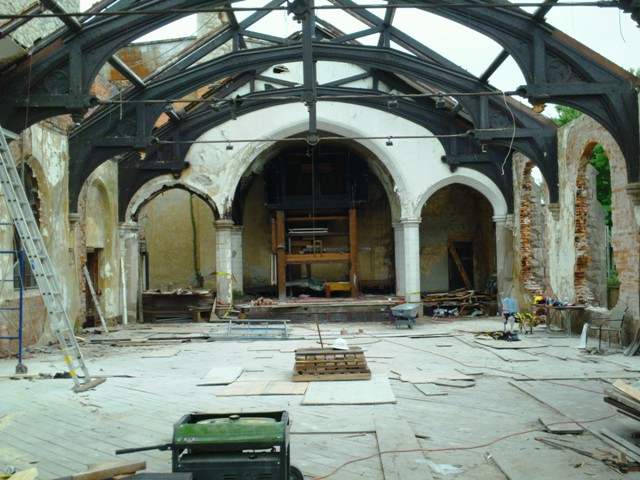

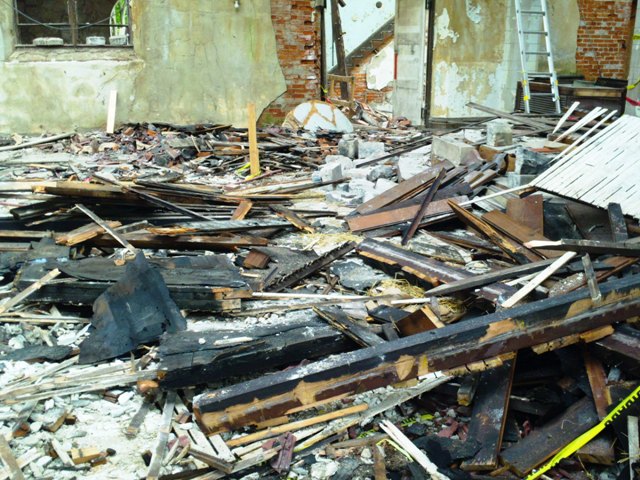

Roof Debris                                                   Clean Sanctuary Work Area

Rented back yard of neighboring house

October 27-28

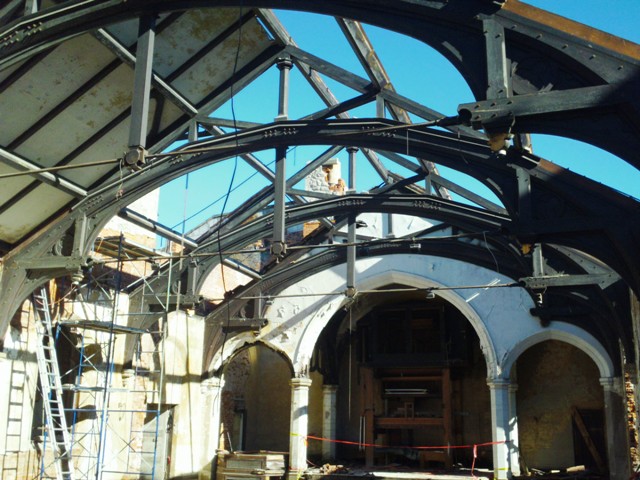

With the roof panels gone, can prepare to lift the trusses.

First, the atrium and west wall have to be removed.

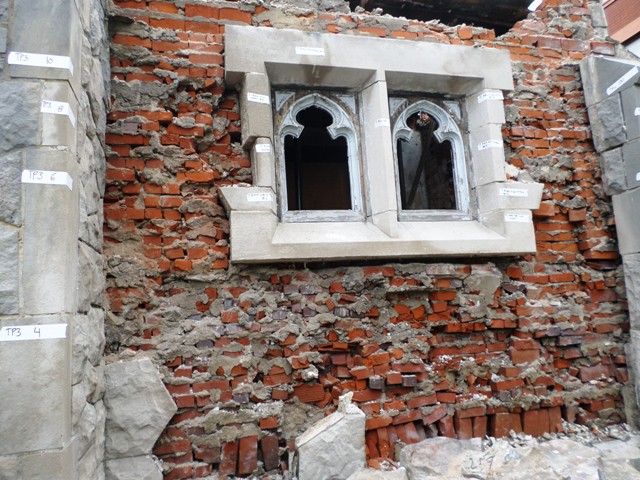

Disassembling the north and south atrium walls.

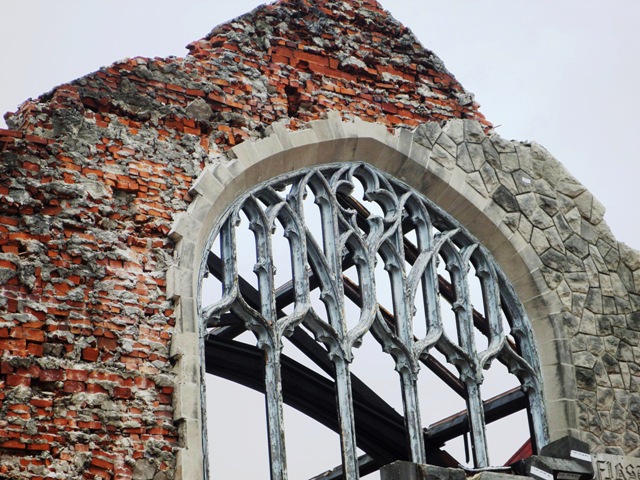

And the main west wall.

The original church door.  The archway entrance is complex. Stone TD36 is a single stone.

Palletizing these shaped stones will be challenging.

Stone removal tools .. The long T-head crowbar is crucial to fast stone removal.

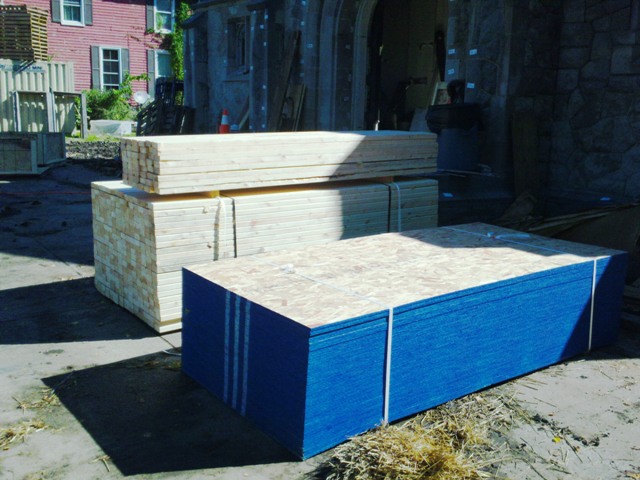

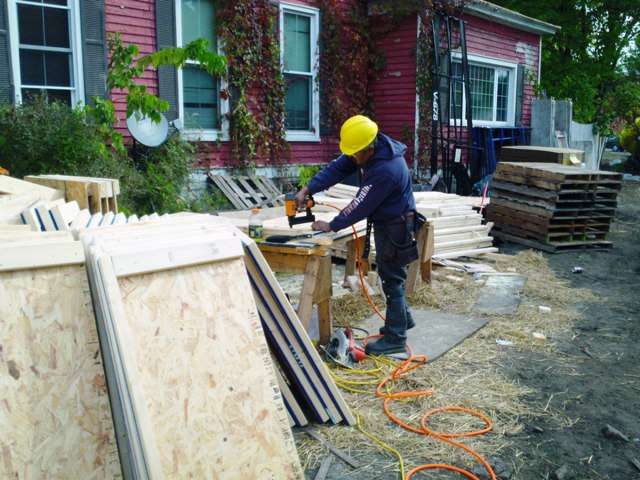

 Jauquin building pallets.  Carpentry is a big portion of shipping stone.  Panels for pallets.

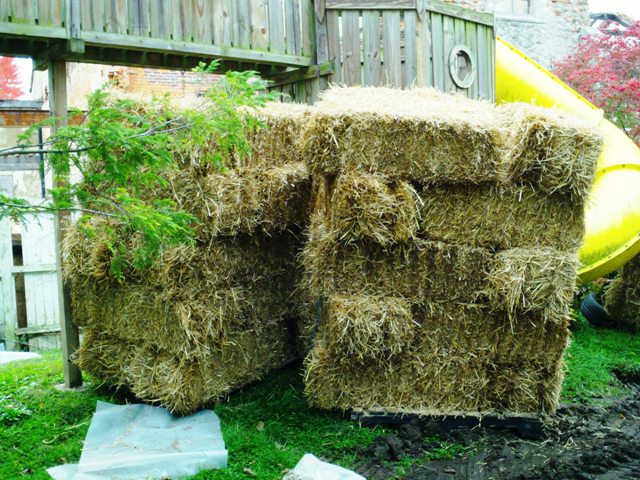

Corrugated used to separate layers of stone, and straw to buffer them.

When the atrium and west wall are removed, we will remove enough of the floor of the sanctuary to allow the high lift to enter the building and lift the trusses one at a time for disassembly.

Go to November

Go to September
